Vacuum Housing Upgrade from Configuration 1 to Configuration 2

Parts and Materials Required

  • Panther Systems with Serial #s lower than 00281 also require:
    • DUCT 7 FAN KIT
    • VAC HSG
    • CHILLER RAMP
  • Combination hex wrench set
  • 4 mm long handle hex driver
  • 5 mm long handle hex driver
  • Flat blade screwdriver
  • Hex driver set
  • Loctite 222 or 242
  • Phillips head screwdriver
  • Tubing cutter
  • Zip ties

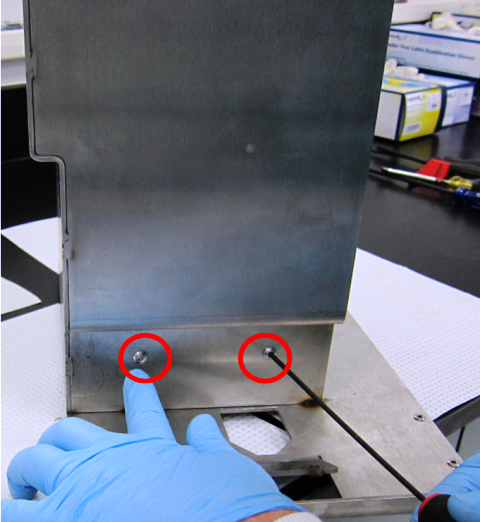

  • VACUUM HOUSING

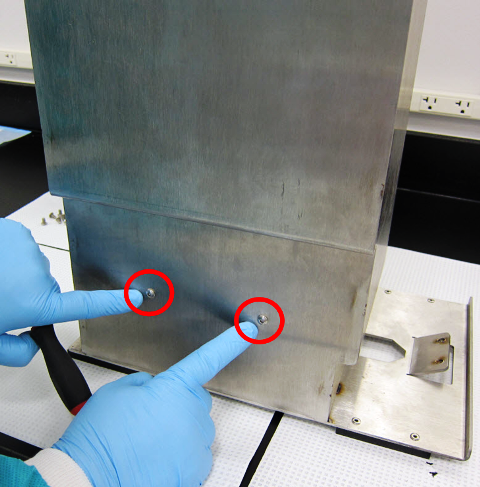

  • PCB, VACUUM PLL CU

Time Required

  • 2 hours

Procedure

  1. Put on proper PPE.
  2. Power down the Panther System.

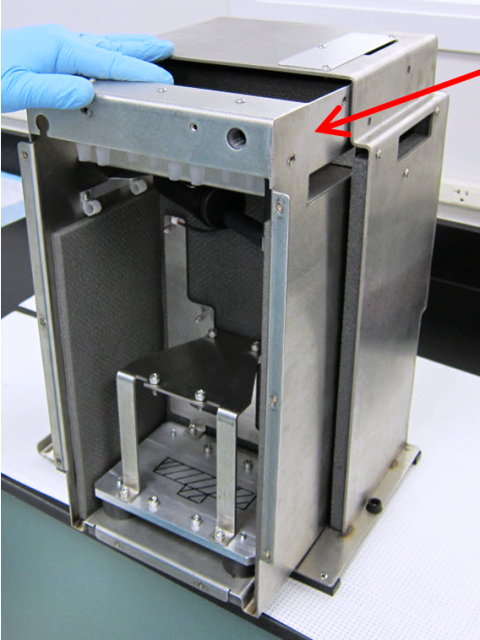

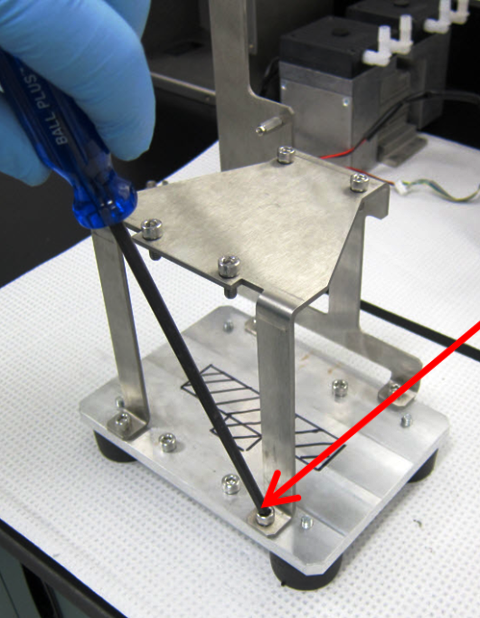

  3. Remove the Bleach, Wash Buffer, and Deactivation Buffer bottles from the Universal Fluids Drawer.

  4. ClosedRemove the Universal Fluids Drawer.

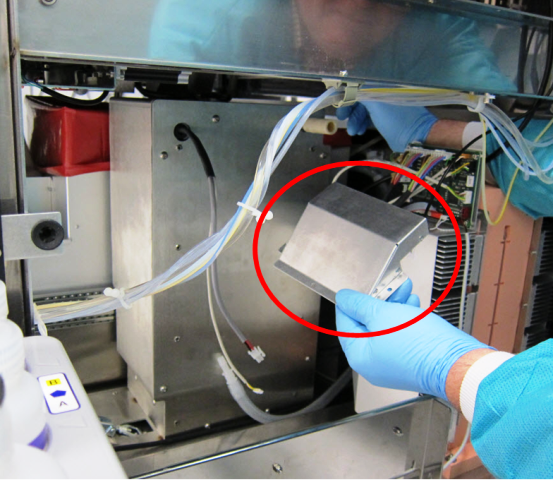

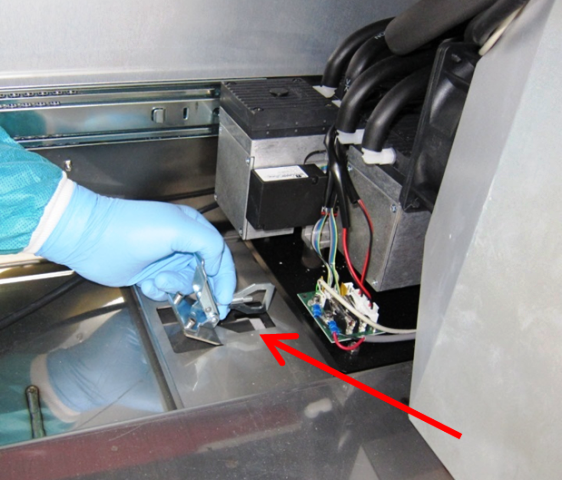

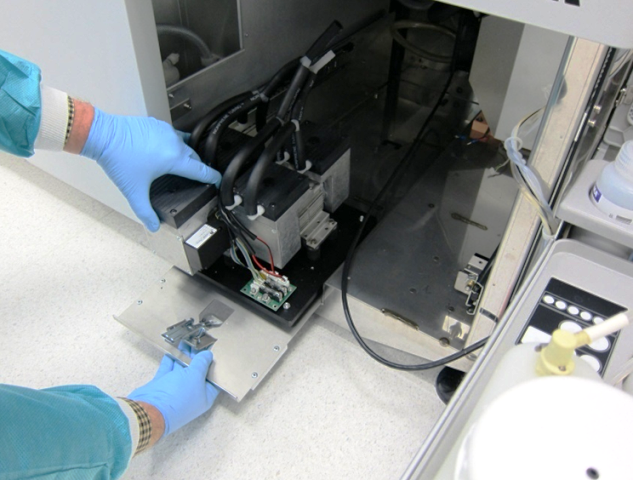

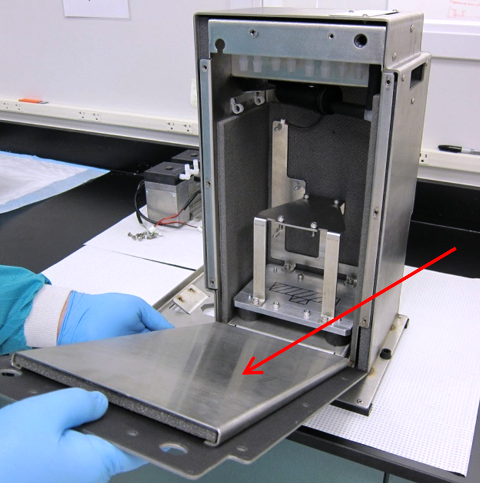

  5. ClosedRemove the Vacuum Module.
    Note—Do not lift the Vacuum Module by the vacuum fittings.
  6. ClosedRemove the vacuum pumps from the Vacuum Module base by removing the 8 mounting screws from the mounting feet of each of the pumps.

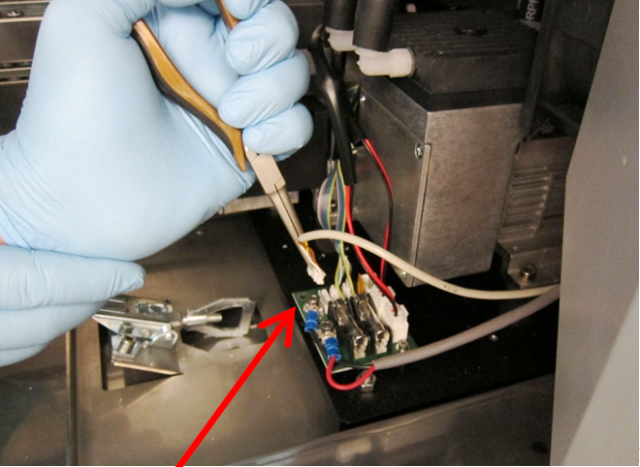

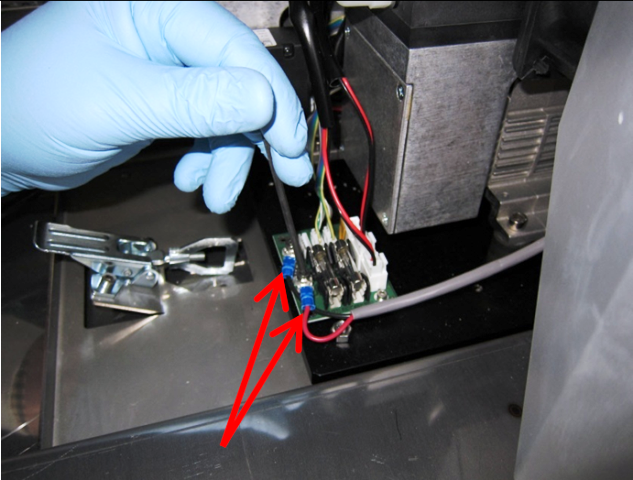

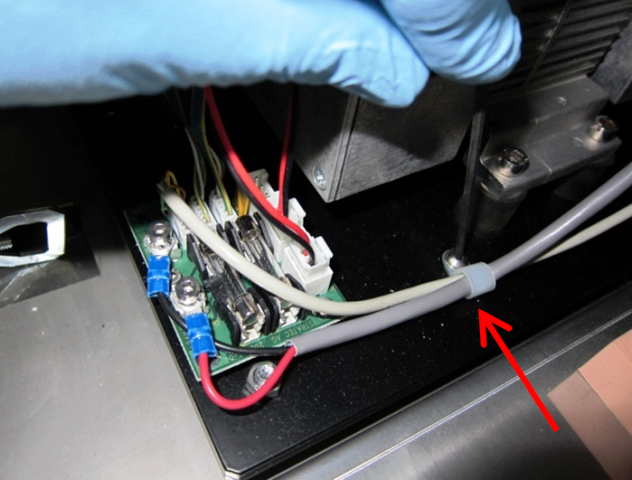

  7. Disconnect the power and control cables from the PCB.

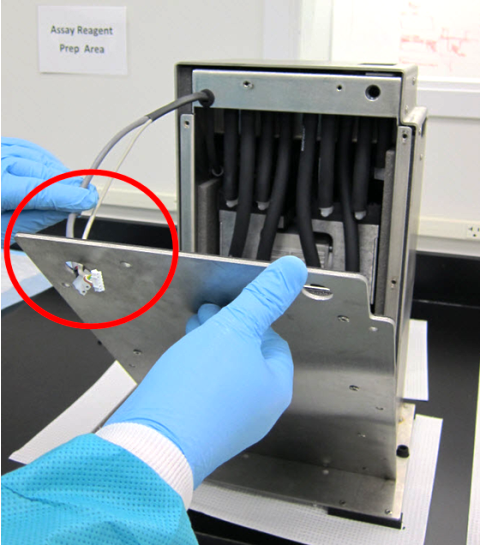

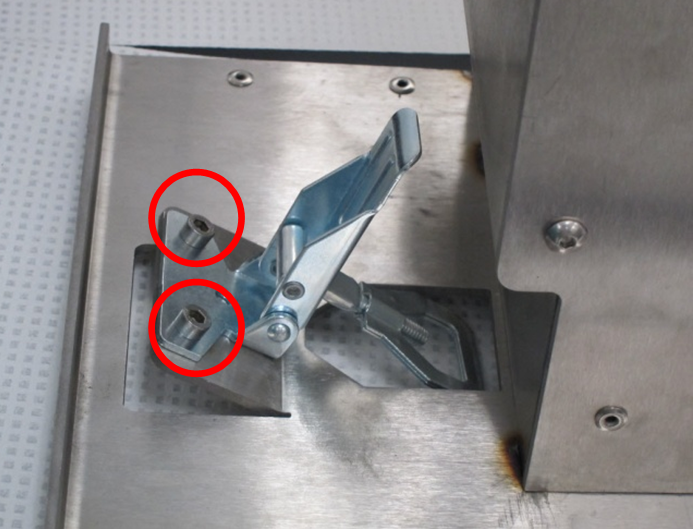

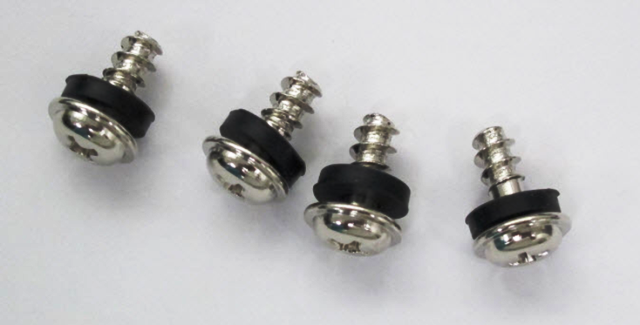

  8. Remove the buckle mechanism and its mounting screws. Do not discard the buckle and mounting screws—they will be used on the new housing.
    Note—Do not discard the original base.

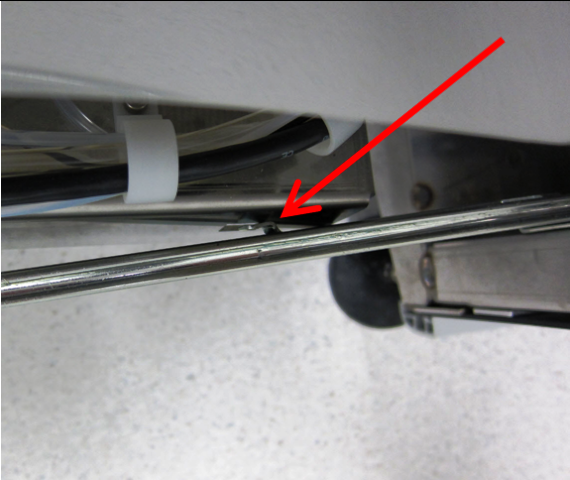

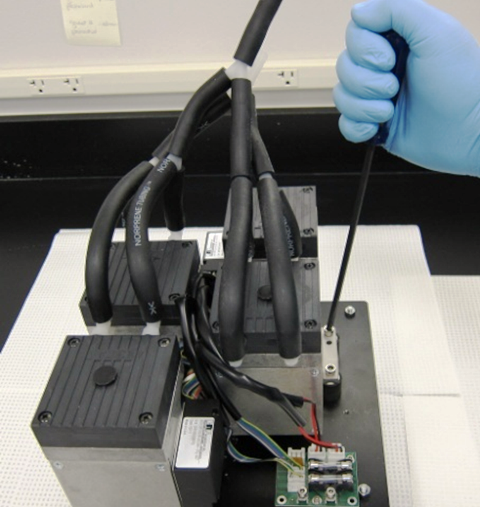

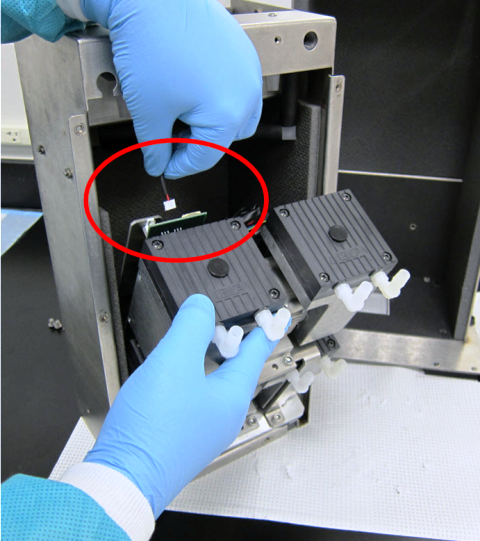

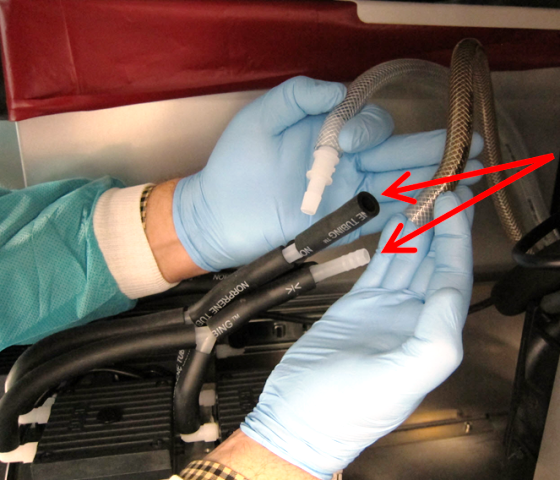

  9. ClosedDisconnect the black Norprene tubing sets from the pump head right-angle fittings.
    Note—Be very careful not to break the fittings on the head.

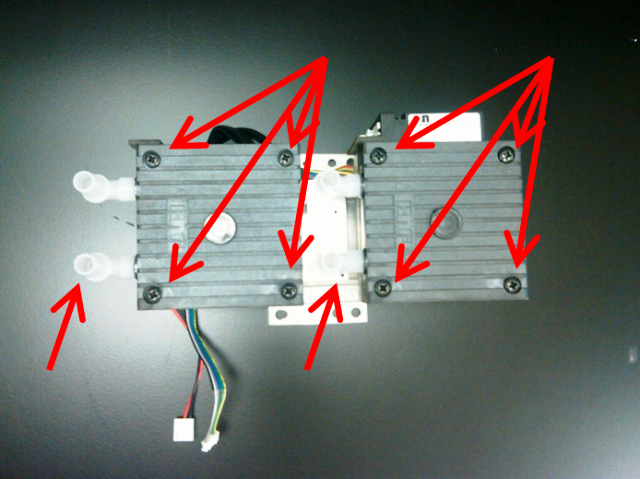

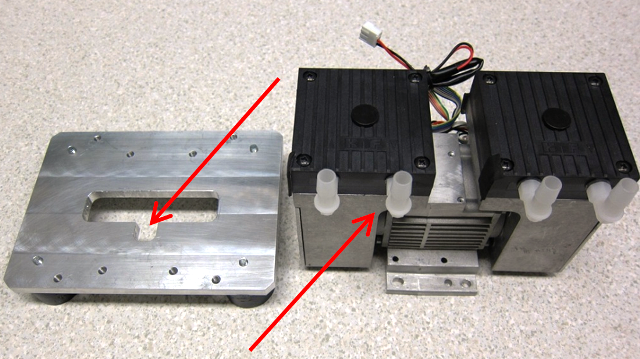

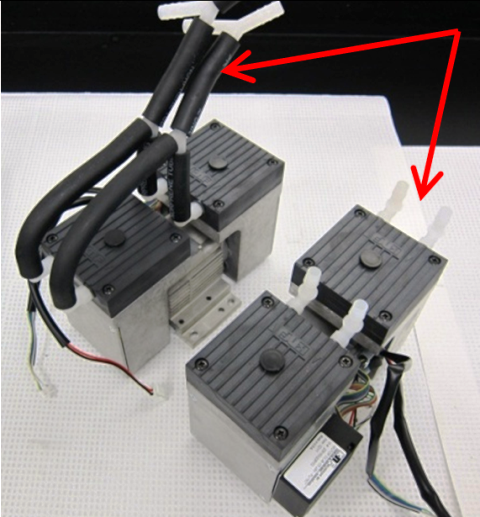

  10. ClosedRemove the 4 pump head mounting screws on each of the vacuum pump heads.

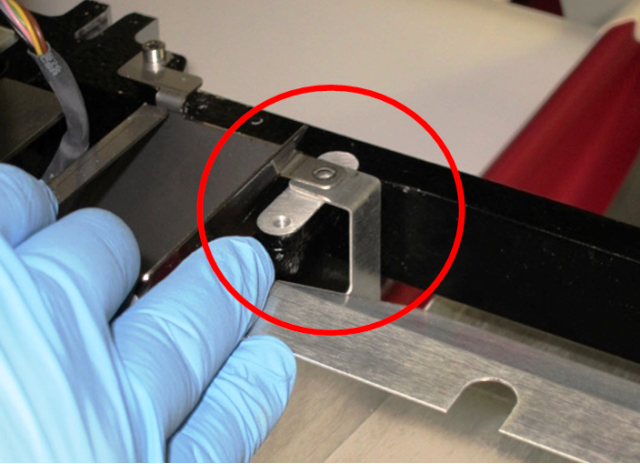

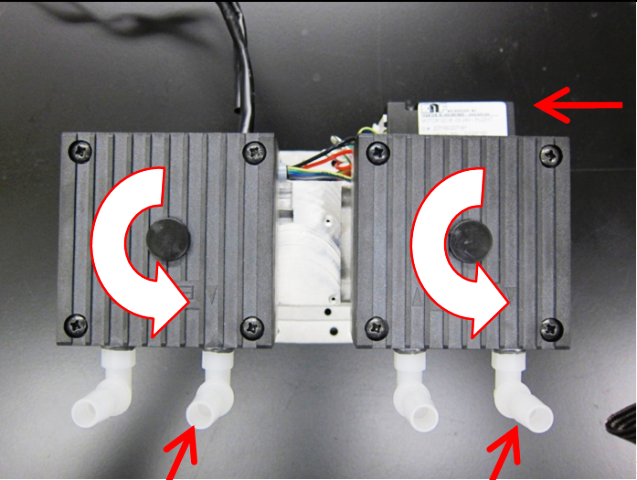

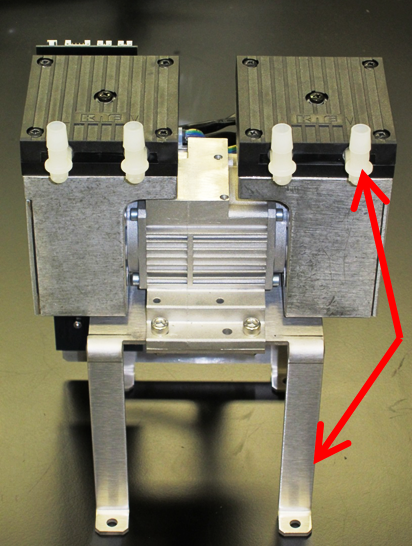

  11. ClosedRotate the pump head 90° so that the input/output barbed fittings are opposite the pump controller. Perform this operation on both pumps. It is not necessary to disassemble the pump head by removing the center screw.

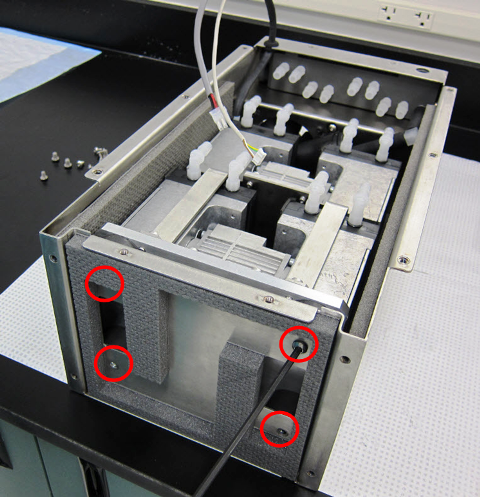

  12. ClosedDisassemble the new vacuum housing in preparation for installing the pumps.

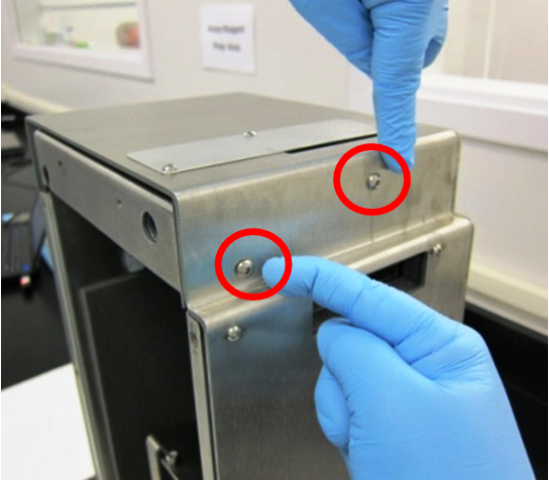

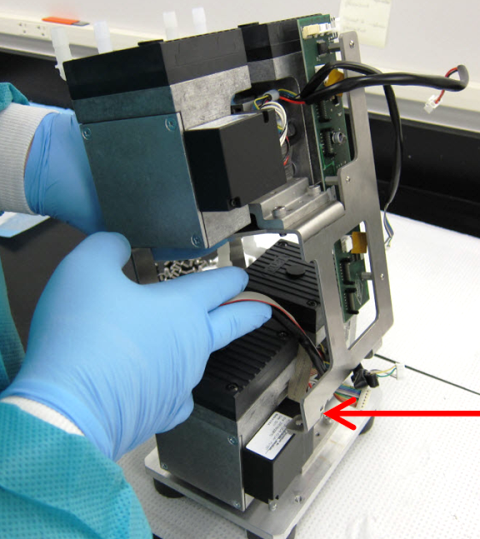

  13. ClosedUsing 4 M6X14 SHCSs, install one pump on the new housing pump base. Orient the pump so that the fittings are on the side of the notch T-shaped feature in the base. The pump controller should be on the opposite side.
  14. ClosedPrepare the cables.

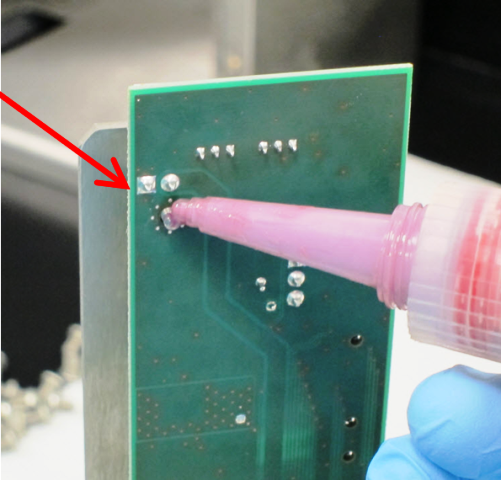

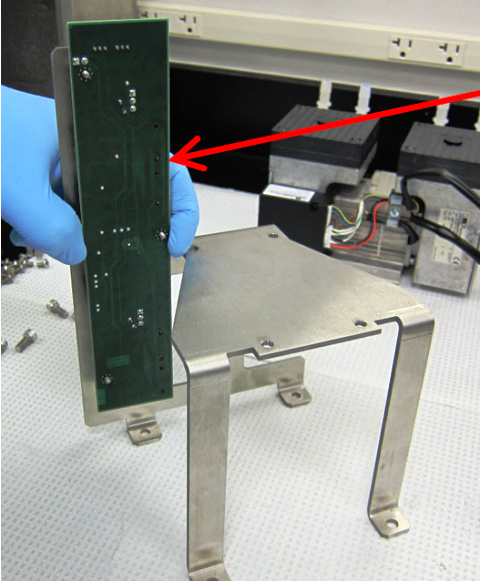

  15. ClosedMount the new PCB.

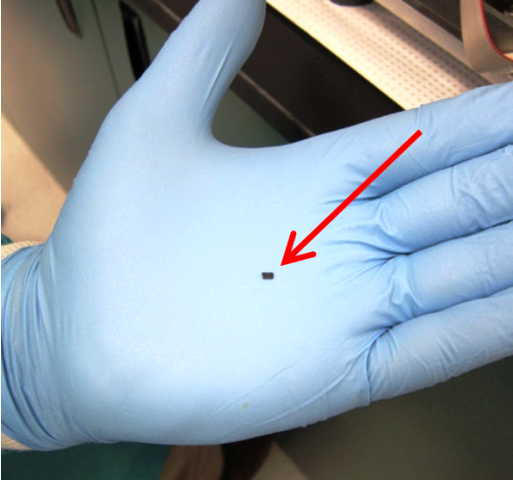

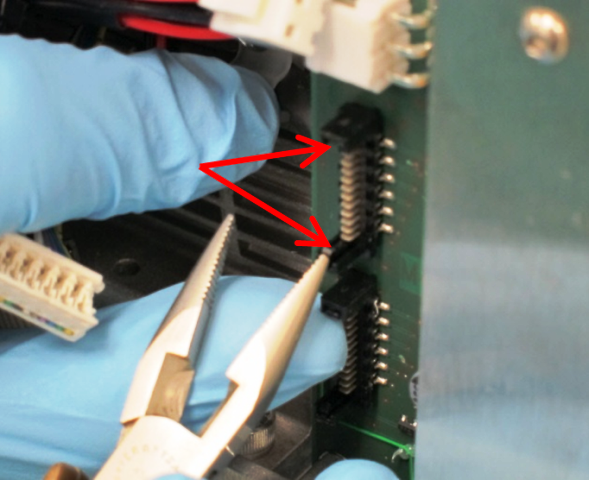

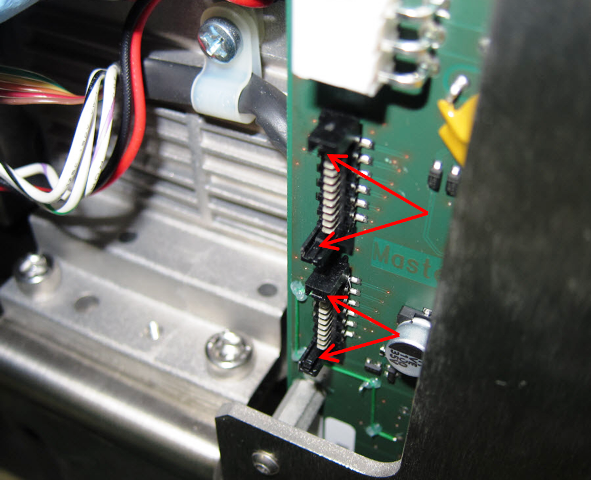

  16. ClosedOptional: Snap off the 8 connector locks to ease future servicing. The lock is a small flexure on the inside of the connector post that is easy to break off. Do not snap off the entire post—only the small flexure.

  17. ClosedUsing 4 M6X14 SHCSs, install the upper pump onto the bracket. The fittings of the pump should face the skinny legs of the bracket.

  18. ClosedInstall the mounting bracket and upper pump onto the pump base by vertically sliding the bracket over the lower pump. The upper pump should be oriented so that the inlet/outlet fittings are on the same side as the lower pump fittings. The bracket will have to be spread apart slightly to fit over the lower pump controller. Fasten the bracket to the base with 4 M6X14SHCSs.

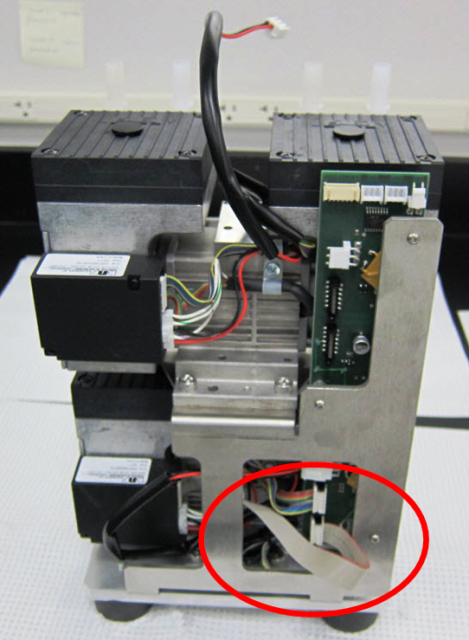

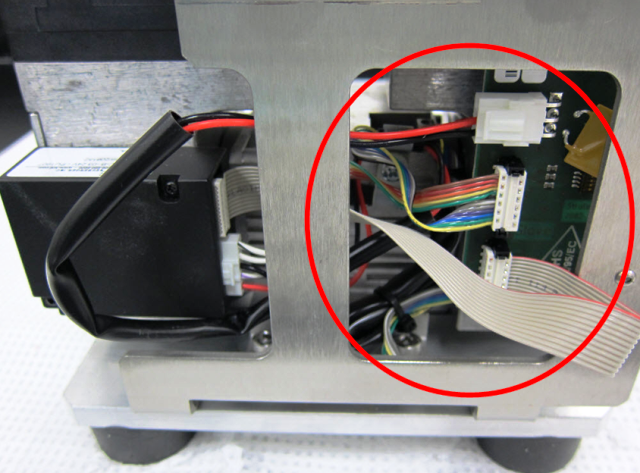

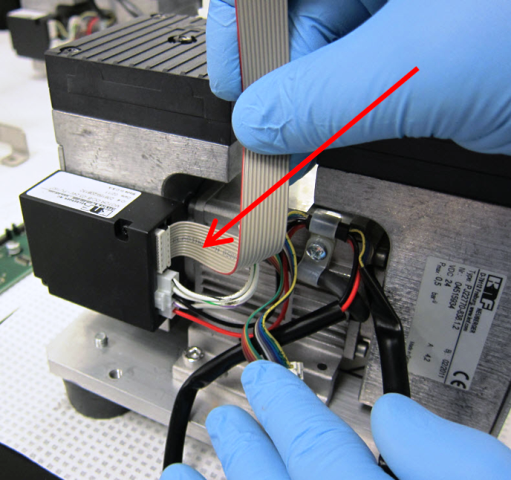

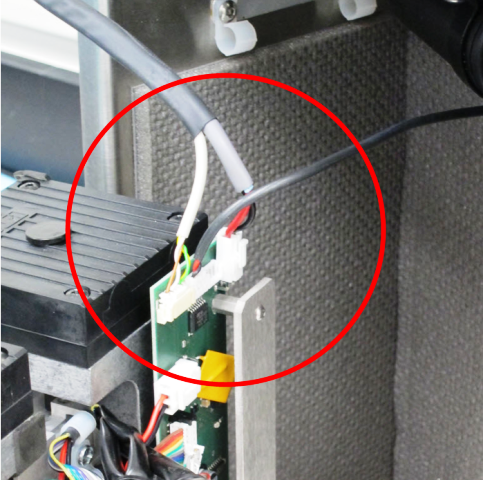

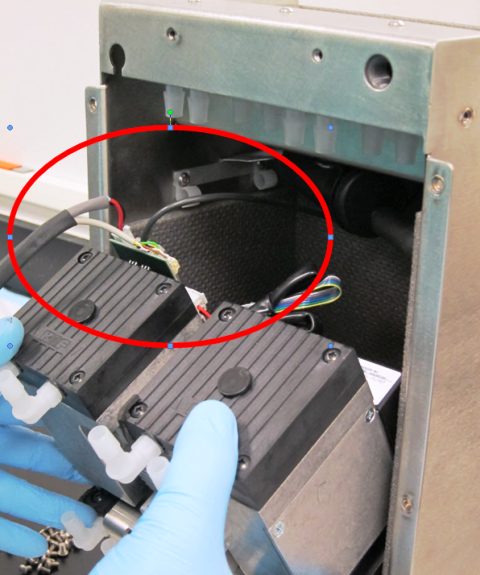

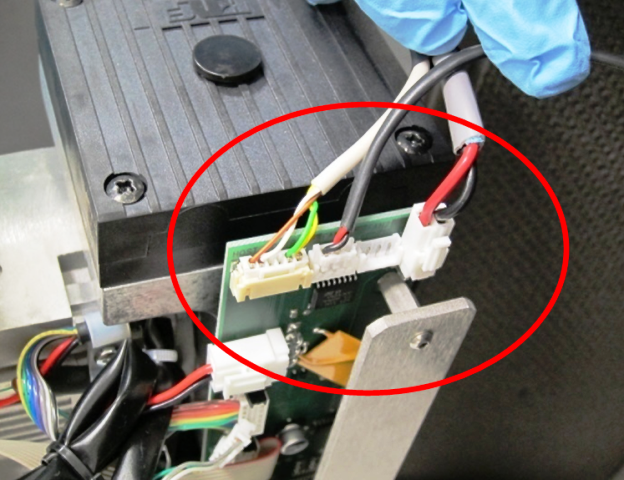

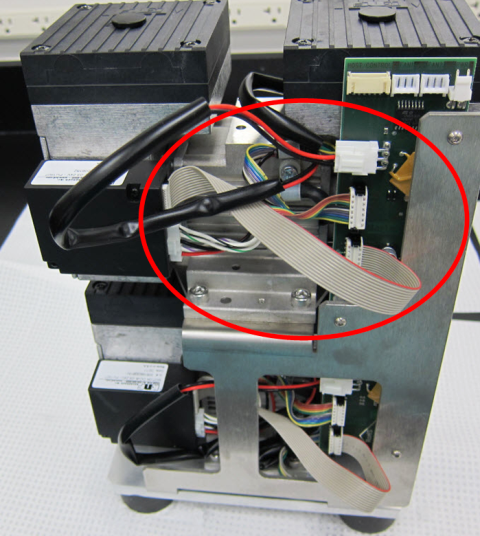

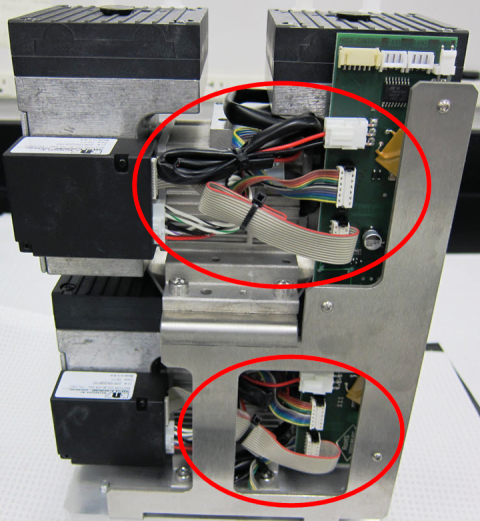

  19. ClosedConnect the ribbon cable from the pump and the new ribbon cable from the controller to the new PCB.

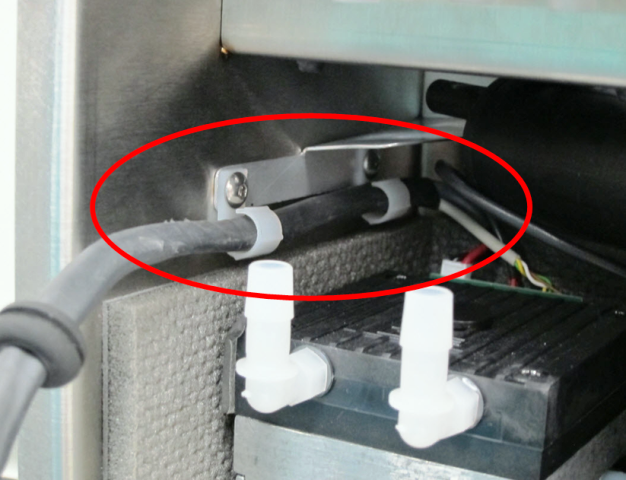

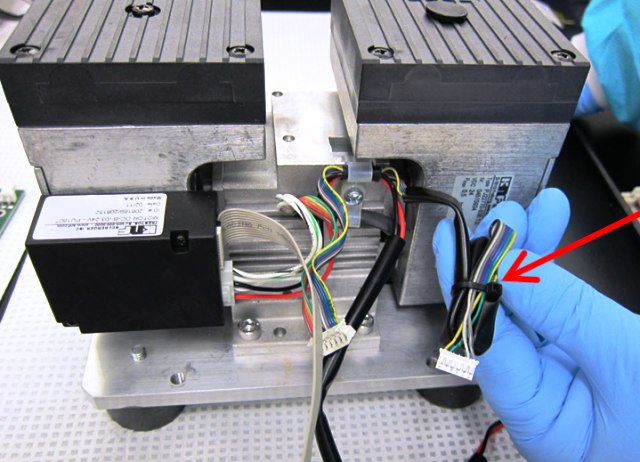

    Note—Note how the new cable is flipped over to make the connection. The striped side of the ribbon cable is on the bottom at the pump control box, and then flips to the top at the PCB connector. The connectors are polarized with narrow and wide slots that match up to narrow and wide posts on the mating connector. Zip tie the cables so that they are tucked away neatly.

  20. ClosedLoad the vacuum pumps assembly into the inner housing.

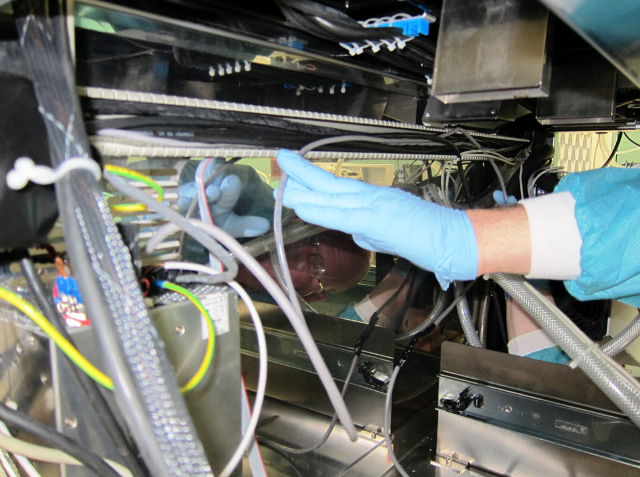

  21. ClosedRoute the power cables.

  22. ClosedUsing a 4 mm Allen key, secure the stacked pump assembly into the inner housing with 4 M6X8 BHCSs from the bottom of the inner housing.

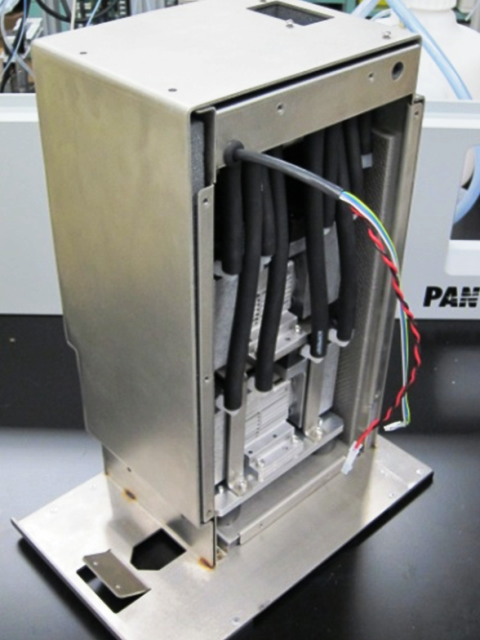

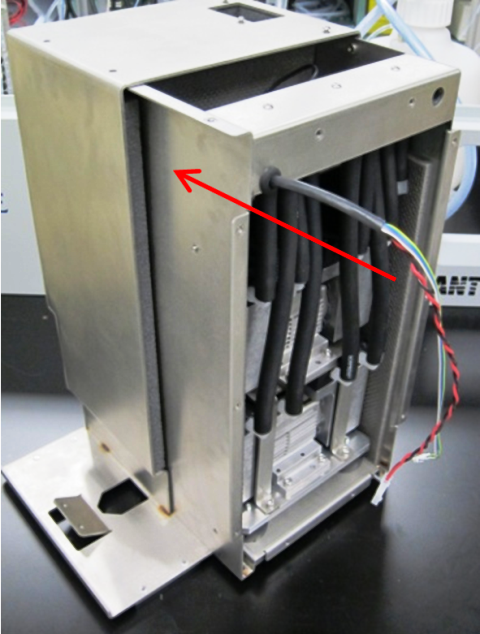

  23. ClosedSlide the inner housing into the outer housing. Be careful not to pinch your fingers.

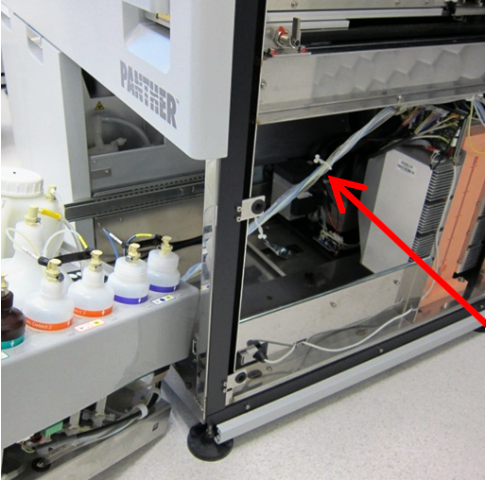

    Helpful Hint—From this point forward, it is up to the discretion of the field engineer to move the installed vacuum housing to the floor by the system. This is to help prevent heavy lifting of the vacuum housing.

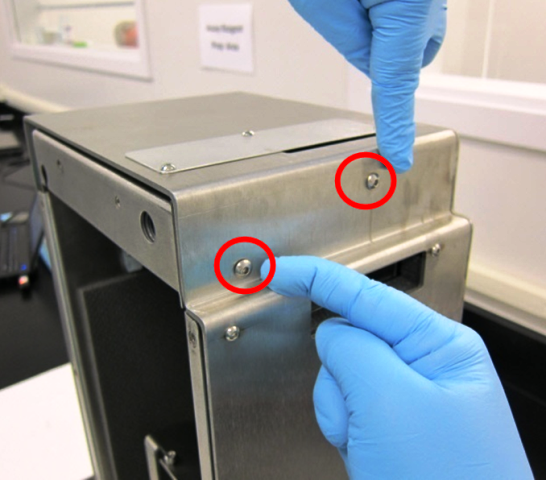

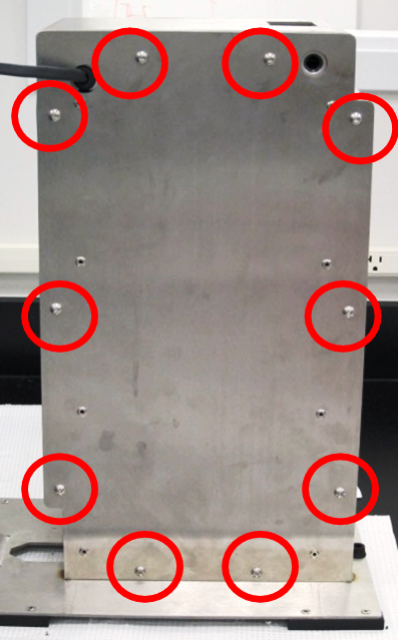

  24. ClosedUsing a 3 mm Allen key, secure the inner housing with 10 M5X10 BHCSs.

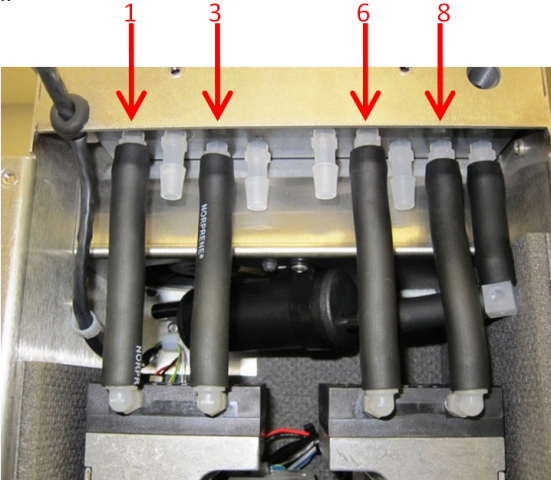

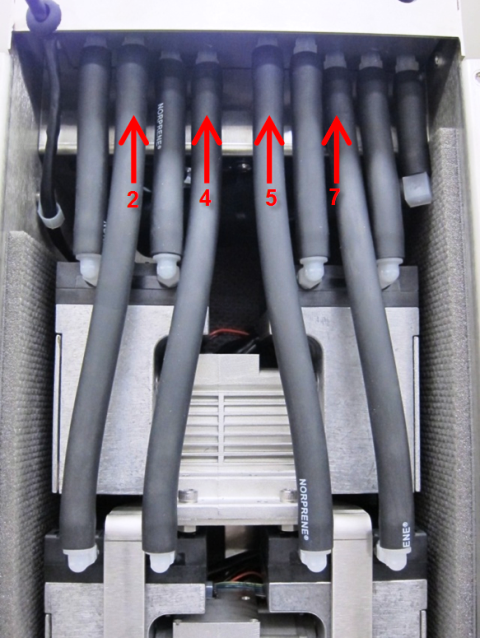

  25. ClosedInstall 8 new pieces of black Norprene tubing from the pumps to the manifold.
    WARNING—Correct connection is critical.

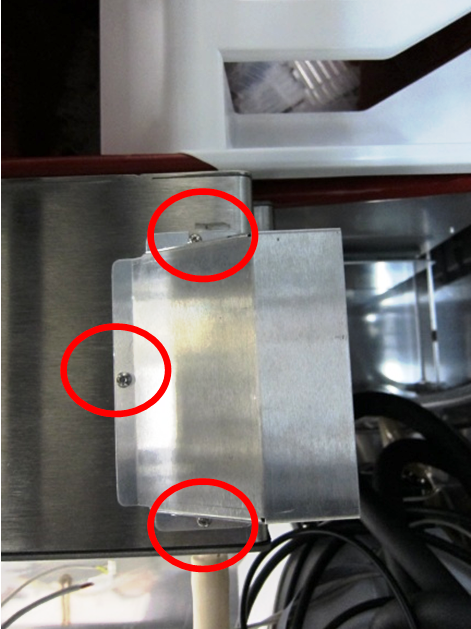

  26. ClosedInstall the front cover.

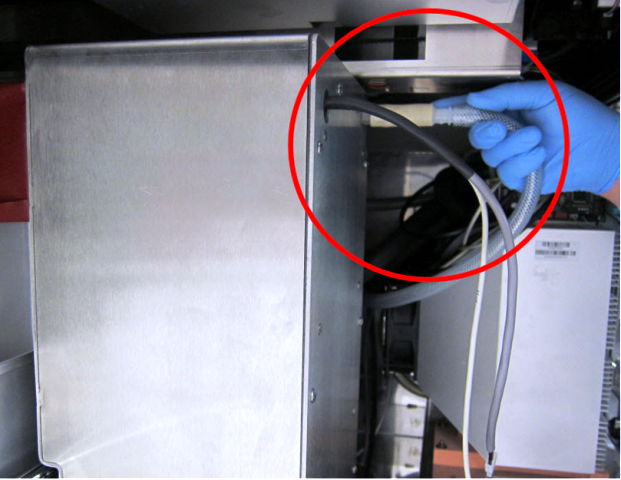

  27. ClosedInstall the inlet tubing.

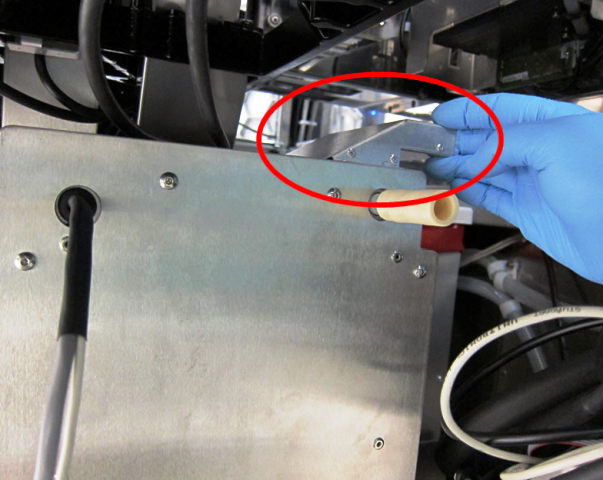

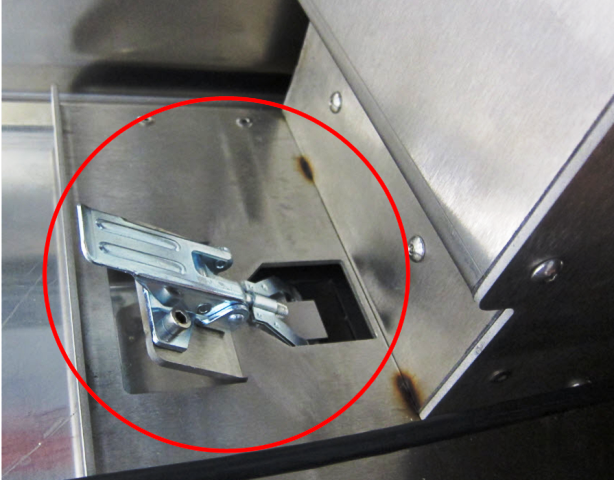

  28. ClosedInstall the fitting assembly and buckle.

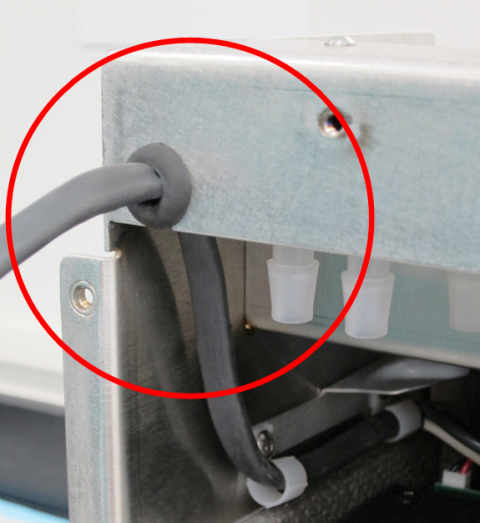

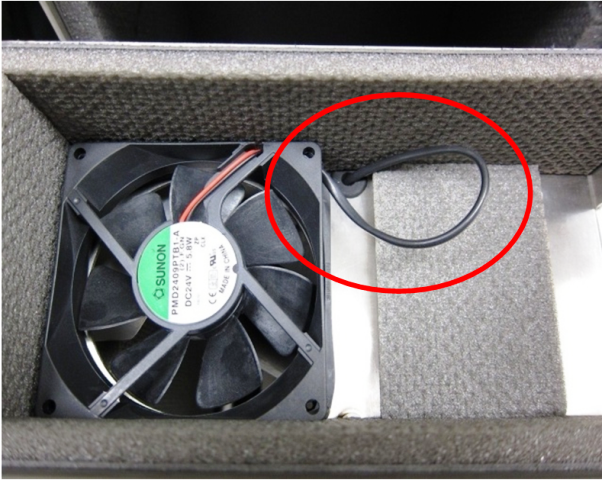

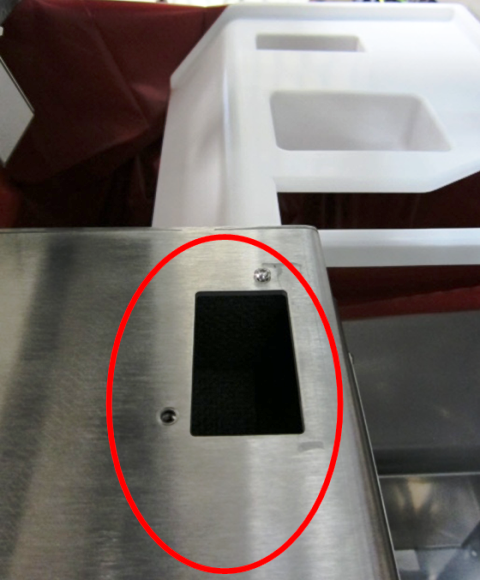

  29. ClosedPrepare the vent:

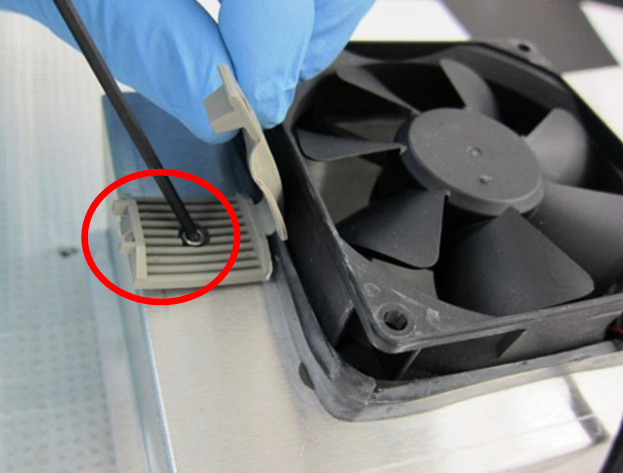

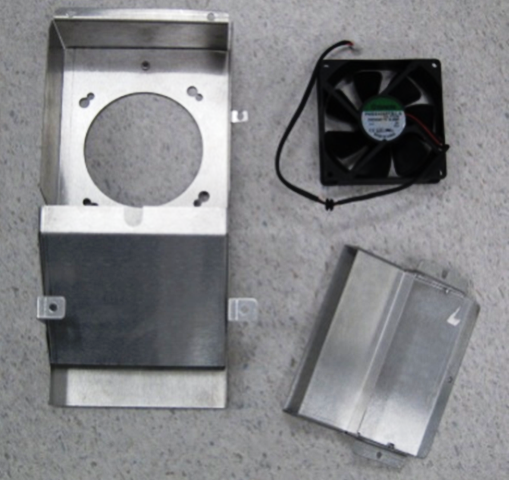

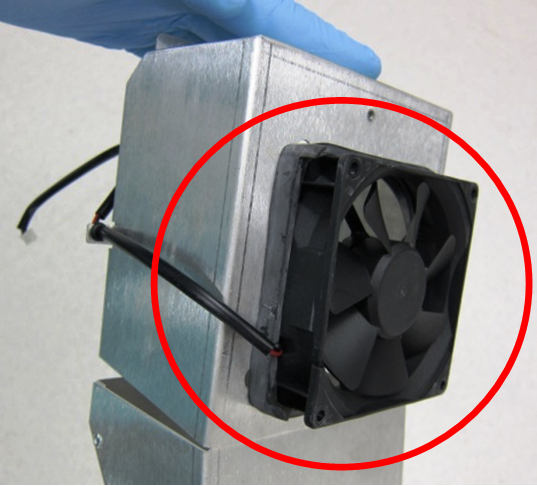

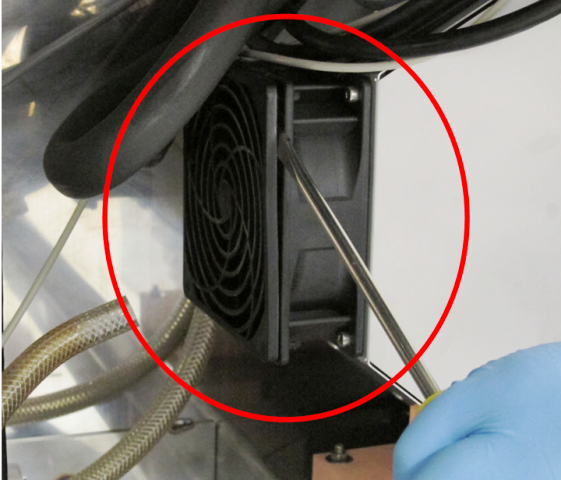

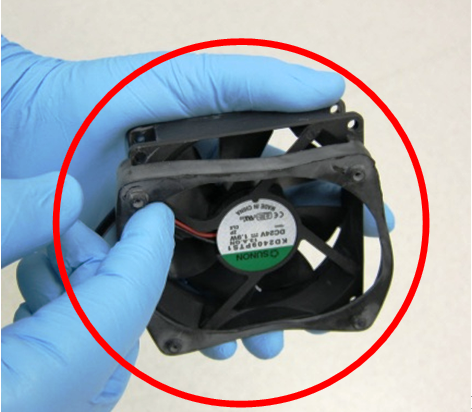

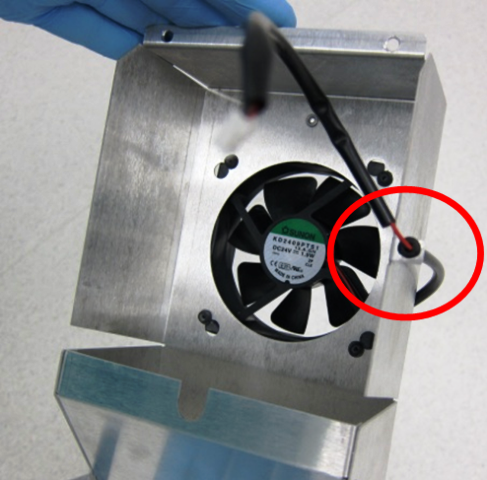

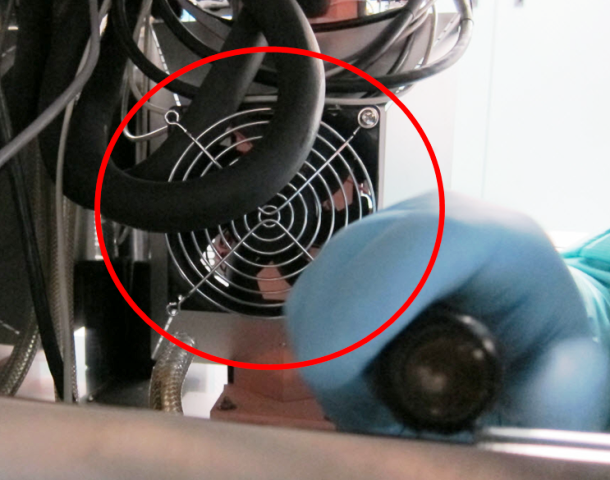

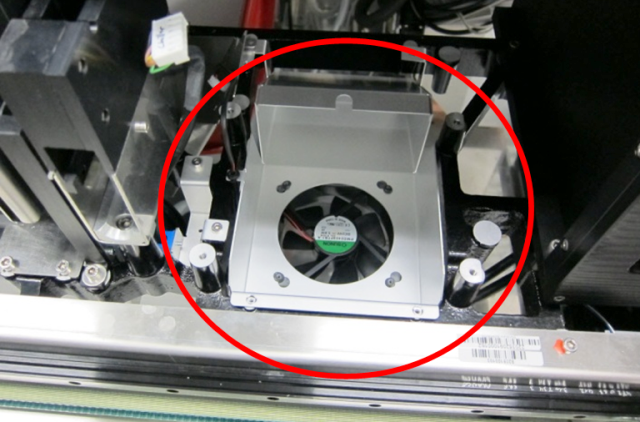

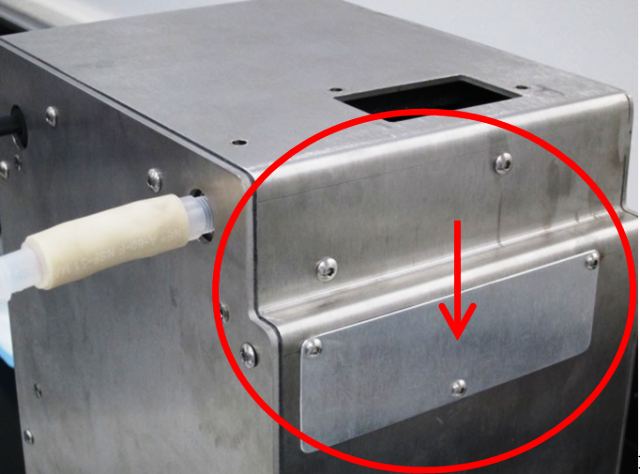

  30. ClosedUpgrade the fan guard on the Cooling Module.

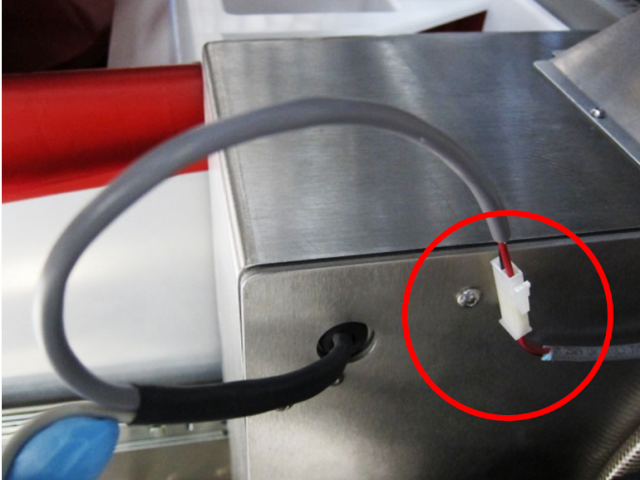

  31. ClosedPrepare power for the new vacuum box. (It may be helpful to remove the power supply from the system.)

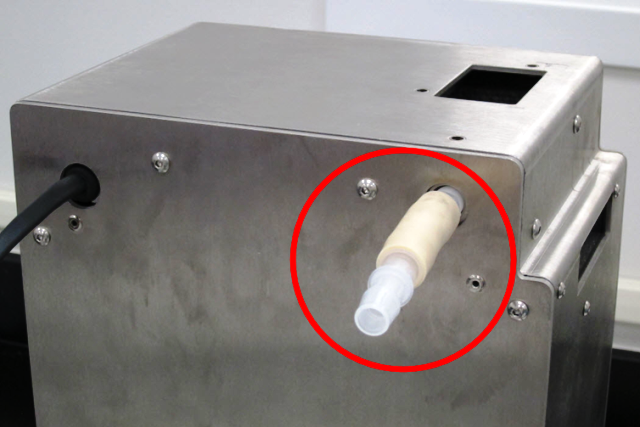

  32. ClosedCut off the barbed fitting at the end of the tubing from the waste drawer and discard.
  33. ClosedRemove the existing (dual) muffler and exhaust tubing from the system. (The new vacuum box has an internal muffler and a new exhaust system.)
    1. Although not required, removing the Cooling Module may be helpful.
    2. Remove the dual muffler assembly (refer to Installation of the Secondary Vacuum Muffler).

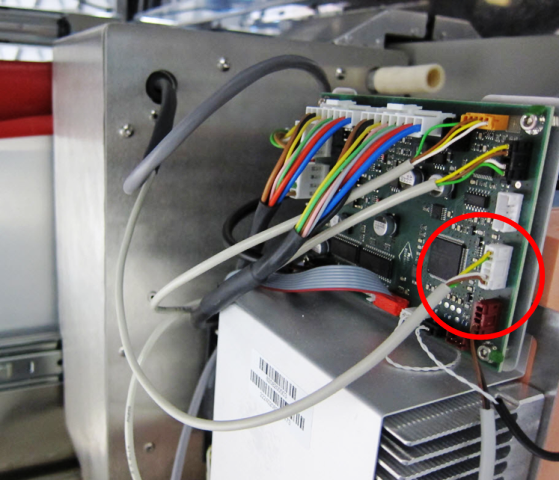

  34. Remove and discard the existing control cable between the pump and the Cooling Module PCB.

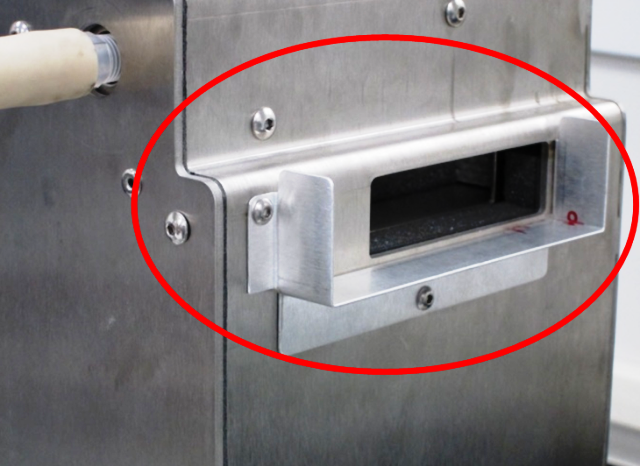

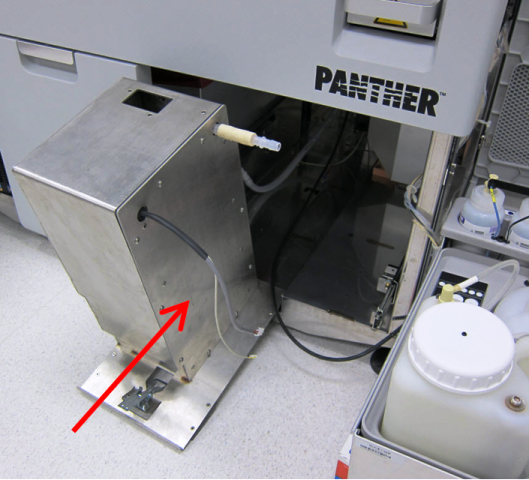

  35. ClosedFor newer Panther Systems (Serial # 00281 and greater), no further system modifications are necessary. Install the new vacuum housing module with the rear vent already attached to the vacuum box.
  Note—For older systems (Serial #s 00280 and lower), follow the instructions below for Chiller Ramp Upgrade for Older Panther Systems before installing the vacuum box.

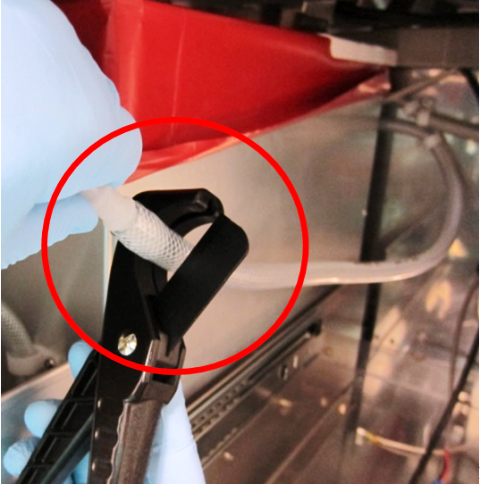

Chiller Ramp Upgrade for Older Panther Systems (Serial #s 00280 and lower)

ClosedOlder Panther Systems share the Chiller Ramp exhaust vent to exhaust hot air from the vacuum housing. This procedure describes modifications to the Chiller Ramp and installation procedures for the top vent on the vacuum housing.

  1. ClosedReconfigure the Chiller Ramp for systems Serial #s 00280 and lower.
  2. ClosedInstall the vacuum housing upper duct to share the Chiller Ramp vent with the new Chiller Ramp duct.

Verification

  1. Power on the Panther System.
  2. In Service Software, check to see if the vacuum is running.
    1. Launch Service Software.

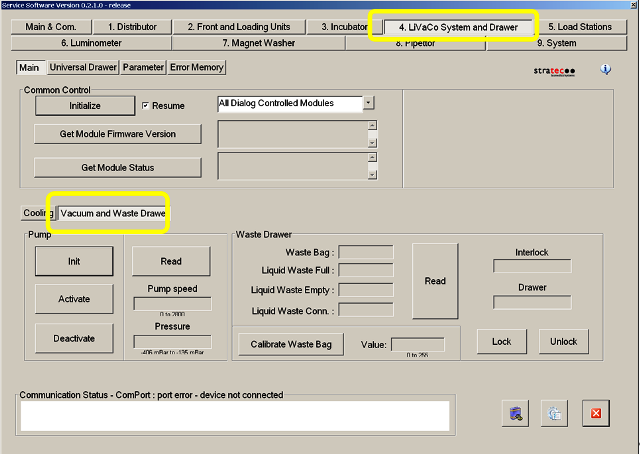

    2. ClosedIn the LiVaCo System and Drawer tab, select Vacuum Waste Drawer.

    3. ClosedIn the Pump section, select Init and then Activate.

    4. Allow the system to run for at least 5 minutes.

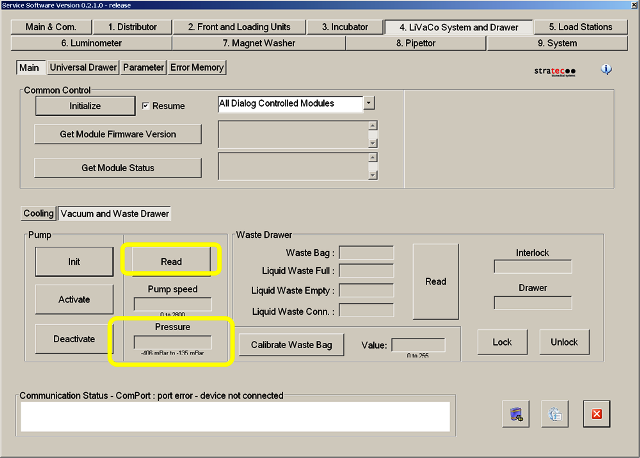

    5. ClosedTo read the manifold vacuum level for each configuration, select Read in the Vacuum and Waste Drawer window.

    6. Make sure to re-optimize the Panther System ported manifold since the new vacuum box is a little more restrictive.

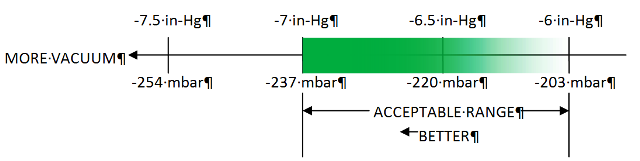

      ClosedSince the new Vacuum Box has a slightly more restrictive internal manifold connecting the pumps together, the Panther System ported manifold may need to be re-configured to achieve the optimum vacuum level. The optimum level is between 203 and 237 mbar vacuum. Vacuum levels greater than 237 mbar will cause the PID control system to start acting to control the pumps, which may result in the beating sound. Vacuum levels less than 203 mbar are not desirable for system performance. The optimum range is shown in green in the figure below, which is displayed as negative millibars (mbar) pressure to correspond to the values that will be displayed in Service Software. The Panther System main software provides the vacuum level in units of inches of mercury (in-Hg).

      Start with the manifold cover port configuration with the lowest vacuum level so that the PID control system is not acting to control the vacuum level, and the pumps are forced to run at full speed. Increased airflow into the manifold through the ported manifold cover reduces the vacuum level. Therefore, the configuration that will result in the lowest vacuum level is the “both ports open” configuration (neither port plug screws installed), which should be the initial “as installed” configuration. The left port has a larger diameter air pathway than the right port. Therefore, the second configuration should be the “left port open, right port plugged” configuration followed by the “right port open, left port plugged” configuration. Finally, the “both ports plugged” configuration provides the highest vacuum level.

    7. Once the vacuum level is set correctly, the installation is complete.
    8. Using the Panther System Main software, perform a System PrimeClosedOperation of pumping fluid through tubing to ensure proper and consistent fluid delivery (remove air from the tubing, etc.). to verify that the vacuum system functions properly during Magnetic Wash Station aspiration.
  3. Verification is complete.
